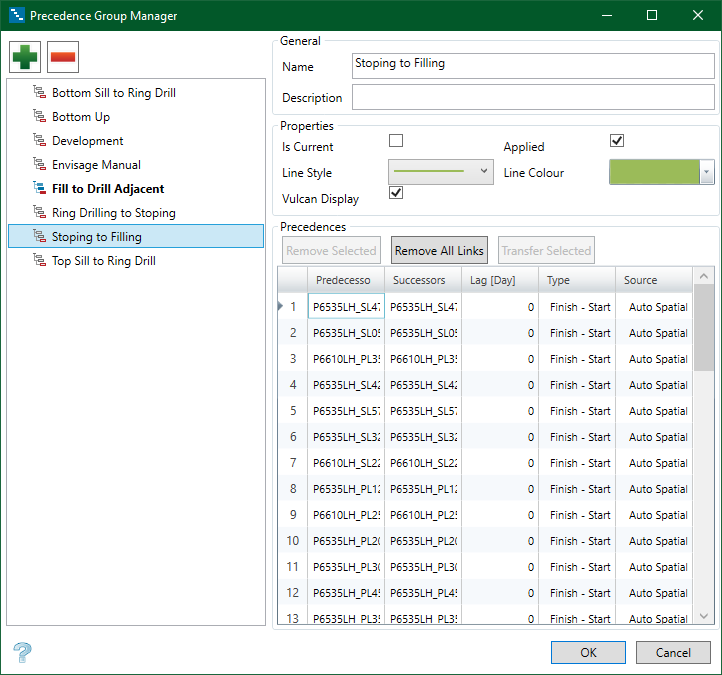

Group Manager
Use the Precedence Group Manager panel to add, edit, and remove precedence groups.
Instructions
On the Precedences tab, in the Precedence Group group, click Group Manager to display the Precedence Group Manager panel.
|
|
Add a new item. (Insert) |
|
|
Remove (Delete) |
General
Name
Enter a name for the group.
Description
Enter a brief description of the group.
Properties
Is Current
Select this checkbox to make this precedence group the current group.
Applied
Select this checkbox if you want the precedences from this group to be applied. Clear this checkbox if you do not want the precedences from this group to be applied.
Line Style
Select a line style for the precedence. This line style will be used for the precedence in the Gantt Chart area.
Line Color
Select a color for the precedence. This line color will be used for the precedence in the Gantt Chart area.
Precedences
Remove Selected
Highlight activities in the list and then click Remove Selected to remove the activities from the precedence group.
Predecessors
Displays the predecessor of the activity.
Successors
Displays the successor of the activity.
Lag [Day]
Displays the lag time between the precedences.
Type
Displays the type of precedence, such as Finish-Start or Start-Finish.
Source
Displays the source of the precedence, such as whether the precedence was created in the Gantt Scheduler or in Vulcan.
